AL FURSAN, RIYADH · MEASURED YESTERDAY

Turning Construction into Mass Production.

Three villas per working day, per production line.

One set of aluminum panels is bolted together, filled with concrete, stripped, and carried to the next plot. Then it happens again. It will happen about 4,300 times before this program is finished.

Nobody waits for a monthly report to learn the rate. Every panel on the site carries a QR code. Every pour is logged the minute it happens. The rate above was measured, which is the only reason we are willing to print it.

That is what a construction company looks like when it is run as a factory.

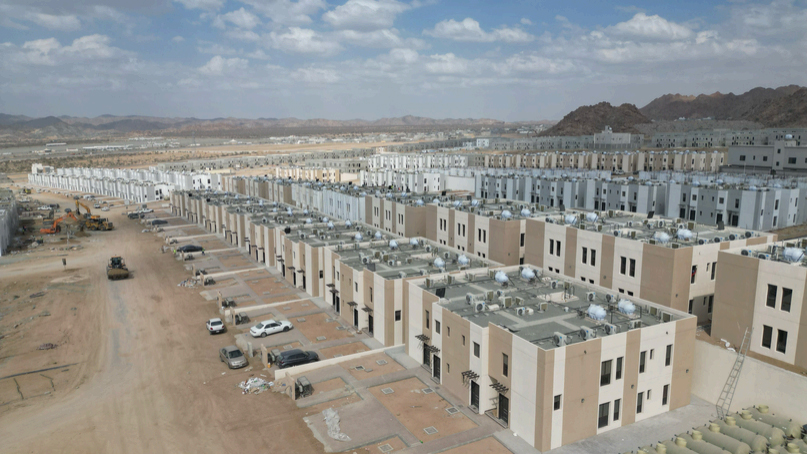

Rows of completed villas at Ebayya in Al Fursan, Riyadh, with the next block still in formwork
Ebayya at Al Fursan, Riyadh. 1,075 villas. The same panels build all of them.

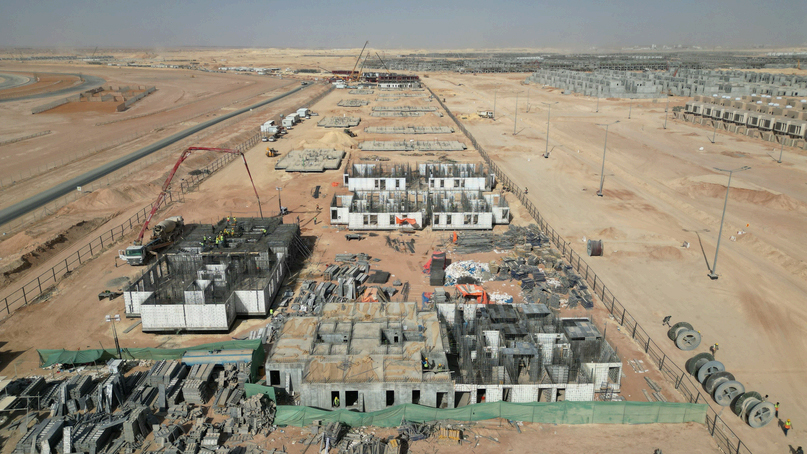

TAKT production twin showing the Ebayya line and its forecast constraint
TAKT logs every pour as it happens, which is how the rate above is known by lunchtime.

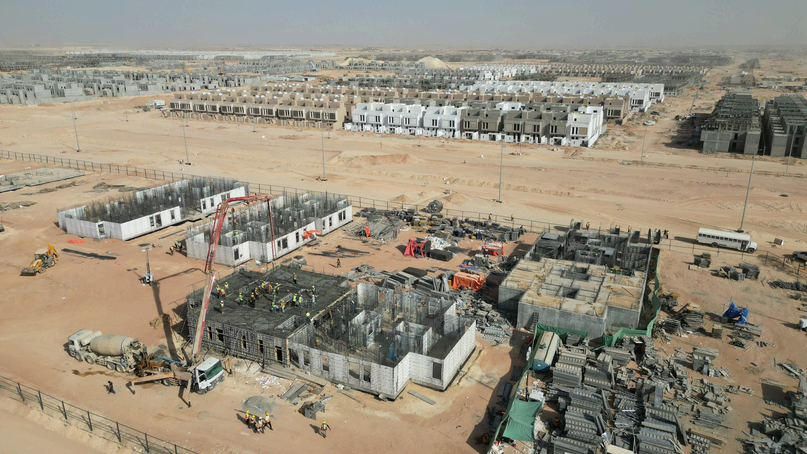

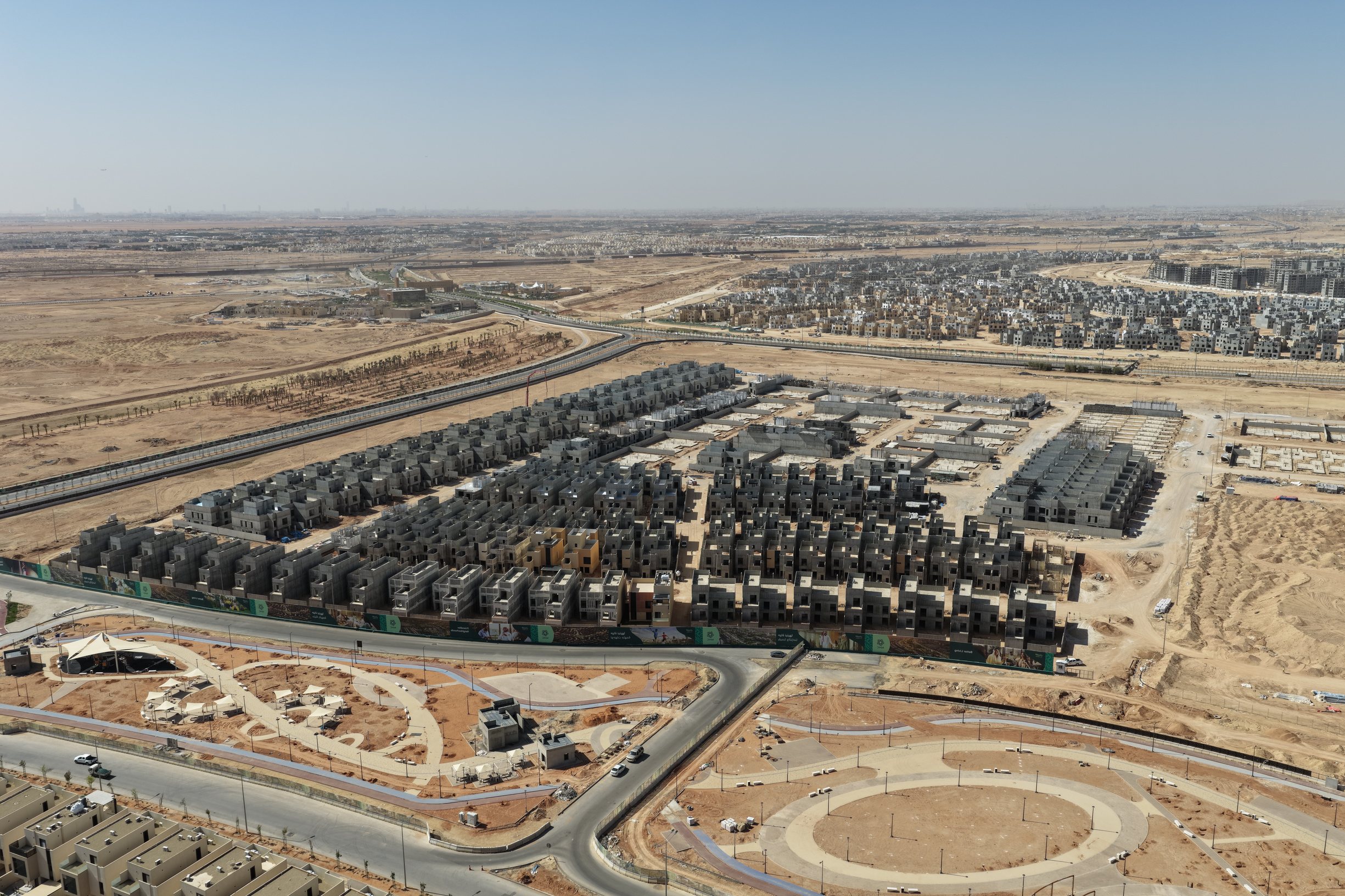

Aerial view of the Ebayya housing program in Al Fursan, Riyadh
About ten thousand panels are on this site. Each one is scanned in and out of every villa.

EBAYYA AT AL FURSAN, RIYADH

1,075VILLAS
3PER WORKING DAY · PER PRODUCTION LINE
~4,300POURS
336,337M² BUILT-UP

Rows of completed villas at Ebayya in Al Fursan, Riyadh

THE PROBLEM IS ARITHMETIC

Saudi Arabia needs 1.5 million more homes by 2030. Nobody has enough crews.

Its five major cities are expected to need more than 1.5 million additional homes by 2030, built in a climate where the thermometer passes 50°C.

You cannot solve that by hiring. There are not enough skilled crews in the region, and a shortage does not disappear because a schedule says it should. It can only be solved by getting more finished buildings out of the crews that exist.

That is a manufacturing problem, and manufacturing solved it a century ago. You stop treating each unit as a project. You build a line, you measure its rate, and you improve the rate.

A delay of one day, repeated across a thousand units, costs a thousand days. So does an improvement of one day. At this scale, the small numbers are the only numbers that matter.

START WITH THE RESULT

What do you need to deliver?

Contemporary Saudi villa exterior shown as a home design concept
A 385 m² home on your own plot, handed over in 90 days from notice to proceed.
01

A custom home

Choose the layout, the elevation and the finishes. We standardize everything behind the walls, which is what makes 90 days possible.

Illustrative hotel entrance design concept with guests arriving beneath a lit canopy
Seventy rooms is 70 near-identical production cycles. That is what a hotel really is.
02

A hotel

Seventy rooms to an agreed four-star specification, handed over six months from notice to proceed. Book your staff and your opening date against a handover you can plan around.

Aerial view of the Ebayya housing program in Al Fursan, Riyadh
1,075 villas at Al Fursan. Three leave the line every working day.
03

A residential development

Tell us how many units and by when. We will give you the daily rate that gets you there, and the panel count, crew count and pour schedule that produce it.

Mechanized coating equipment applying finish to an interior wall
Mechanized finishing. The bottleneck usually moves here once the structure speeds up.
04

More contractor capacity

Add structural or finishing output to a project that is behind, without adding another specialist supplier to chase.

01A fully fitted custom home, ready to furnish in 90 days.
02A 70-room hotel to an agreed four-star specification, in six months.
03A development configured for three to six core-and-shell units per working day.

HOW THE LINE ACTUALLY WORKS

Twenty-four sets of formwork. Four pours per villa. One rhythm.

A villa at Ebayya is four pours: ground floor, first floor, roof, parapet. Twenty-four sets of aluminum formwork move through the site, and each set is assembled, poured, stripped and carried to the next villa the following day.

Nothing is consumed. The same panels build villa after villa. They are rated for more than a thousand pours, and we have that in writing, which means one set of panels can build more than 250 villas before it retires.

That is the difference between a construction site and a production line. On a site, the work moves and the building waits. On a line, the building stays and the tooling moves, at a rate you can count.

THREE OF FIVE RUN TODAY. TWO ARE BEING BUILT.

We would rather tell you which is which.

Most construction companies present a roadmap as though it were a catalog. Here is the honest split.

RUNNING NOW01

Industrialized construction

Reinforced concrete walls and slabs poured as one monolithic structure, on a repeating cycle. This is what produces three villas a day at Al Fursan.

RUNNING NOW02

Mechanized paint and finishing

Machine application of primer, putty, sanding and paint, so finishing can keep up once the structure speeds up.

BEING BUILT · 202703

STRUX Manufacturing

Our own formwork plant. Today we buy formwork abroad at SAR 1,884 per square meter, pay for it in advance, and wait three months for it to arrive. STRUX ends that.

BEING BUILT · 202804

Construction robotics

Machine placement for the most repetitive work on site, starting with full-tile flooring.

RUNNING NOW05
TAKT · Turning Construction into Mass Production

TAKT across the line

Our own production intelligence layer. It records every pour and every panel movement as it happens, forecasts what will be ready next, and warns where the line is about to stop.

INDUSTRIALIZED CONSTRUCTION MAKES THE WORK REPEATABLE.
TAKT MAKES IT PREDICTABLE.
ROBOTICS WILL MAKE IT AUTONOMOUS.
TAKT production twin showing formwork panels moving through a construction cycle
TAKT forecasting the next constraint on the Ebayya line.

THE INTELLIGENCE LAYER FOR AUTONOMOUS CONSTRUCTION

See the delay before the site feels it.

Every panel movement and every pour at Ebayya is recorded as it happens, by the foreman, on his phone, in about four seconds.

That gives TAKT something a schedule never has: the actual rate, today, not the reported rate at month end. From it, TAKT forecasts which villa is ready next, where the next bottleneck is forming, and which crew, material or machine is about to be the thing everyone waits for.

The benefit is time. A bottleneck seen three days early is a crew moved. A bottleneck seen on the day is a crew standing still.

01SEE NOW

Know the live state.

02PREDICT NEXT

See readiness and bottlenecks forming.

03ACT EARLY

Move resources before the line loses time.

04AUTOMATE PROVEN DECISIONS

Progress from recommendation to controlled execution.

WHY THIS GETS CHEAPER EVERY TIME

The second site starts where the first one finished.

A contractor is paid for a building, then starts the next one from nothing. Everything the crew learned walks off site with the crew.

A production line does the opposite. Every cycle at Ebayya is measured, compared to what was predicted, and carried forward. The next site inherits panel layouts that are already proven, cycle times that are already known, and a forecast that has already been tested about 4,300 times.

The formwork behaves the same way. The panels are an asset with a rated life above a thousand pours, not a cost that disappears into the job. Once they are bought, every subsequent villa they build costs less than the last.

Three villas per working day is what one production line produces. Nothing in the method caps it there. A second line is a second three, and it opens holding the panel layouts, the cycle times and the forecast that this one spent a year learning.

That is the entire argument for building a construction company this way.

PROOF BELONGS IN THE PHYSICAL WORLD

5,000 homes. 800,000 square meters. Ten years. Go and look at them.

Every case study on this site states the client's requirement, our exact scope, the production method, and the result we can evidence. Where a number is a target rather than a measurement, it says so.

Rows of completed homes at Ebayya in Al Fursan, Riyadh
Ebayya at Al Fursan. Three villas a day, and counting.

THE NEXT PROJECT

Tell us what you need built and when you need it.

We will work backward from the date to the daily rate, and from the daily rate to the panels, crews and pours required to hold it. Then you can decide whether the arithmetic works.
